Introduction

Welcome to PRA! This project provides a set of tools for performing Project Risk Analysis (PRA) using various quantitative methods. It is designed to help project analysts assess and manage risks associated with project schedules, costs, and performance.

Installation

To install the release verion of PRA, use:

install_packages('PRA')

You can install the development version of PRA like so:

devtools::install_github('paulgovan/PRA')

Usage

Here is a simple example of how to use the package for a common PRA task.

First, load the package:

Suppose you have a simple project with 3 tasks (A, B, and C), but the duration of each task is uncertain. You can describe the uncertainty of each task using probability distributions and then run a Monte Carlo Simulation (MCS) to estimate the overall project duration.

To do so, set the number of simulations and describe probability distributions for each work package. In this case, run 10,000 simulations with the following distributions:

num_simulations <- 10000
task_distributions <- list(
  list(type = "normal", mean = 10, sd = 2), # Task A: Normal distribution
  list(type = "triangular", a = 5, b = 10, c = 15), # Task B: Triangular distribution
  list(type = "uniform", min = 8, max = 12) # Task C: Uniform distribution
)

Then run the simulation using the mcs function and store the results:

results <- mcs(num_simulations, task_distributions)

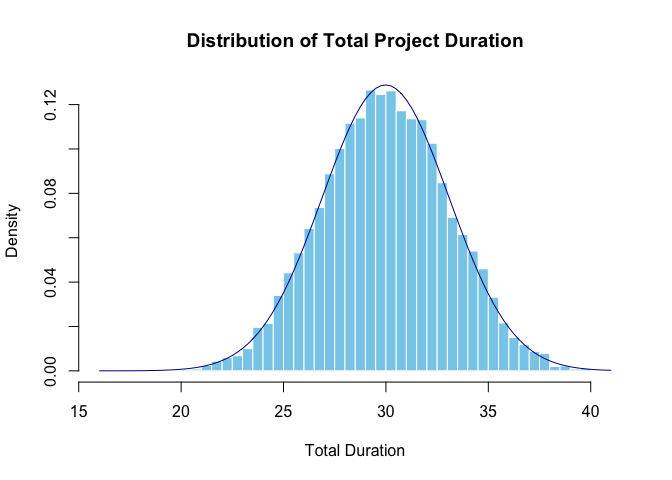

To visualize the results, you can create a histogram of the total project duration. You can also overlay a normal distribution curve based on the mean and standard deviation of the results:

hist(results$total_distribution,
  freq = FALSE, breaks = 50, main = "Distribution of Total Project Duration",
  xlab = "Total Duration", col = "skyblue", border = "white"
)
curve(dnorm(x, mean = results$total_mean, sd = results$total_sd), add = TRUE, col = "darkblue")

This will give you a visual representation of the uncertainty in the total project duration based on the individual task distributions. On average, the project is expected to take around 30 time units, but could take as little as 20 or as much as 40 time units.
